People often expect a new garage door to mean days of disruption, builders in and out, and a driveway blocked all week. A made-to-measure electric roller door is nothing like that. The door arrives ready to fit, there is no structural work involved, and in most cases the fitting team arrive in the morning and are gone before the afternoon is out.
That said, the fitting visit is only the final step. This guide walks through the whole journey in order: the survey, the quote, the manufacturing lead time and then installation day itself, hour by hour. If you want the broader picture of how we work, our garage door installation page covers the full service.
The Full Timeline at a Glance
| Stage | Typical time |
|---|---|
| Free on-site survey | Under an hour |
| Fixed written quote | Provided at the survey or shortly after |
| Made-to-measure manufacturing | A few weeks from approval |
| Installation | A single visit, typically within half a day |
| Handover walkthrough | The final part of the installation visit |
Add it together and the wait is measured in weeks, not months, and the disruption at your home is measured in hours. Now for each stage in detail.
The Free Survey: Under an Hour
Everything starts with a free on-site survey, and for most homes it takes less than an hour. The surveyor measures your opening precisely, checks the headroom above the opening and the side room where the guide rails will sit, and looks at the fixing points and the power supply. All the door needs electrically is a standard 13-amp socket inside the garage.
This is also the moment to talk through the choices: the 55mm slat profile for single garages, the thicker 77mm profile for wider or more exposed openings, and the colour and finish you want. There is no pressure and nothing to sign on the day.
Your Fixed Written Quote
After the survey you receive a fixed written quote for the whole job: the door, the motor, two remote controls, the safety edge, automatic locking, the manual override and the installation itself. The price you see is the price you pay, and the quote carries no obligation. Take as long as you like to decide; the timeline only starts moving again when you approve it.

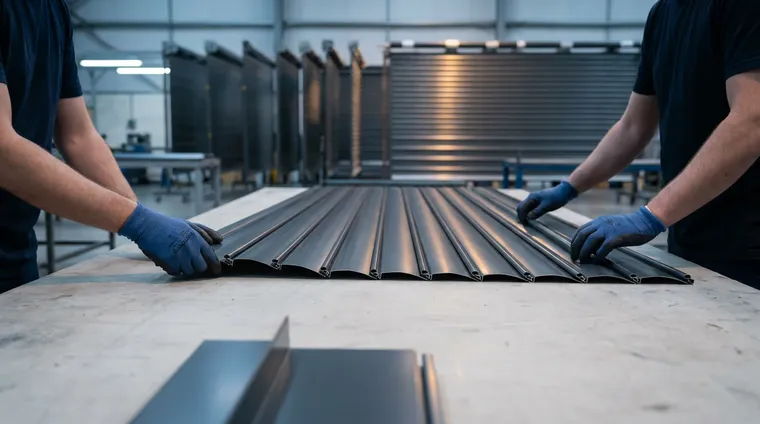

The Manufacturing Lead Time
Once you approve the quote, your door goes into manufacture. Every Rollrite door is made to measure for your exact opening rather than pulled from a shelf, and that precision is what makes the fitting visit so quick. The trade-off is a manufacturing period of a few weeks between ordering and installation. Your surveyor will give you a realistic lead time when you order, and we agree the fitting date with you in advance.
There is genuinely nothing you need to do during this period. A day or two before the visit, it is worth running through our guide on how to prepare your garage for a roller door installation: clearing the opening, checking the socket and sorting parking takes most people less than an hour.
Ready to start the clock? The survey is free, takes under an hour and comes with a fixed written quote.
Book a Free SurveyInstallation Day: Hour by Hour
Here is how a typical half-day installation runs. Exact timings vary from garage to garage, but the order of work is always the same.
- Arrival and old door removal. The team arrive, walk the job with you and get the van unloaded. Where removal has been agreed in your quote, the old door comes out first, usually within the first hour, and is set aside for disposal.

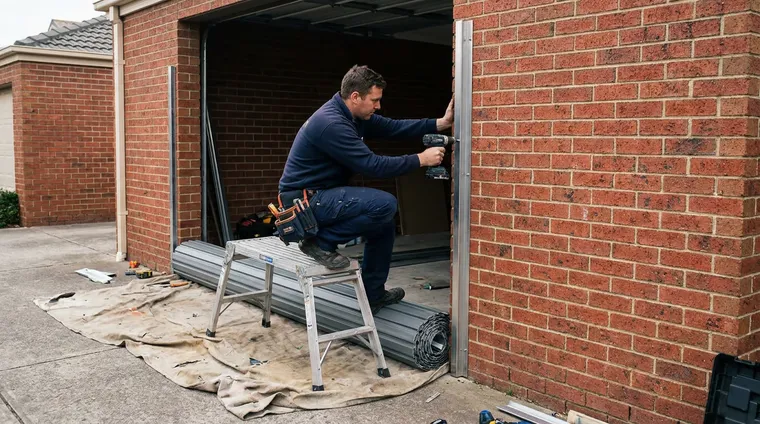

- Guide rails. The aluminium guide rails are fixed plumb and level to each side of the opening. This stage rewards patience, because straight guides are what keep the door smooth and quiet for years afterwards.
- Curtain and top box. The insulated aluminium curtain and its compact top box are lifted into place above the opening and fixed securely. This is the heaviest lift of the day, which is why a clear driveway and a short carry from the van matter.
- Motor and power. The electric motor is connected and plugged into your 13-amp socket. There is no rewiring and no dedicated circuit to install.
- Setting the limits. The fitters programme the open and close limits so the curtain stops exactly where it should at the top and sits snug to the floor at the bottom.
- Safety edge test. The safety edge is tested against an obstruction to confirm the door stops and reverses on contact, and the automatic locking is checked with the door fully closed.
- Remote programming. Both remote controls supplied with the door are programmed and tested, one at a time.
- Handover. The team tidy up, then walk you through the door: the remotes, the safety features and the manual override that opens the door in a power cut. You try everything yourself before they leave.
What Can Extend the Time on the Day
Half a day covers most installations, but a few things can stretch the visit, and it is better to know about them in advance than to be surprised on the day:
- Wider 77mm doors. A double or extra-wide opening on the 77mm profile means a heavier curtain, longer guides and more fixings, so there is simply more to lift, level and test.
- Awkward access. Tight shared drives, limited parking or an opening that is hard to reach all slow the carry and the fixing work. Nothing insurmountable, just slower.
- Old door disposal. A stubborn old frame, a heavy timber door or years of rusted fixings can add time to the removal stage before the new door work even begins.
None of this changes the price, because your quote is fixed after the survey. It simply means the surveyor may tell you to expect a full day rather than a morning, and you will know that before anyone books a date.
The routine is the same right across our coverage area. The team follow the same process fitting roller garage doors in Harlow as they do ten minutes from our Sible Hedingham base: same survey, same checks, same handover.
Still comparing options? Our garage door cost calculator gives you an instant idea of price for your size and spec, and the free survey turns that into a fixed written quote and a firm date whenever you are ready.
